How to edit

Best Practices:

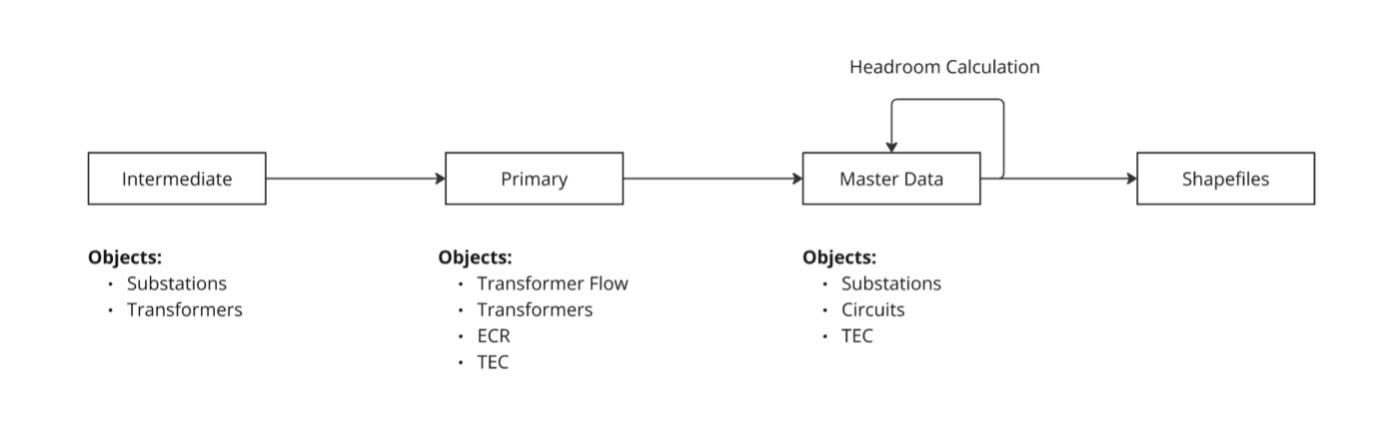

Simplified Data Workflow

How to edit substation

Substations

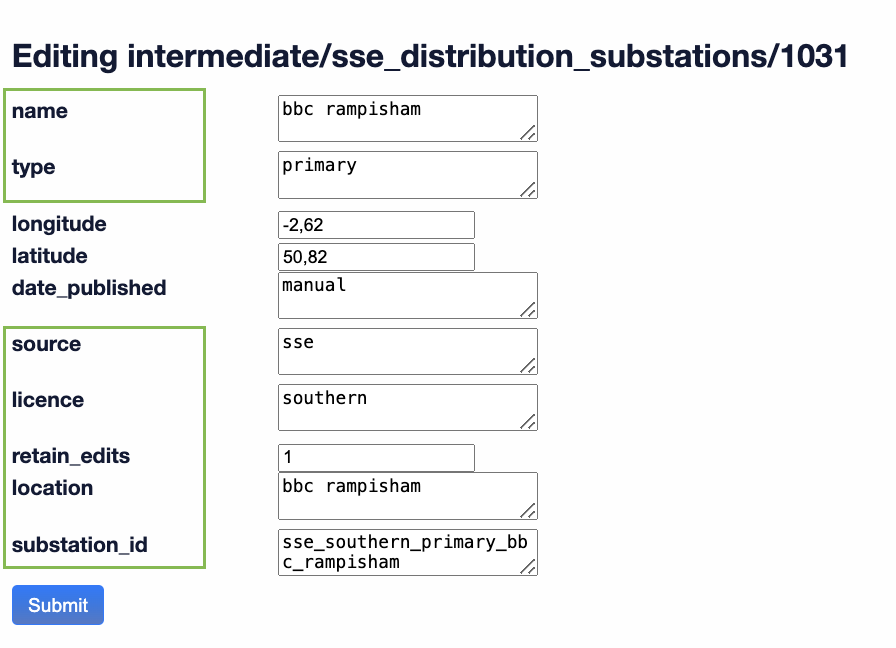

Adding a new substation

  1. Create a new substation entry in the intermediate substation table
  2. Ensure that the fields in green are populated:
How to edit substation

Transformer

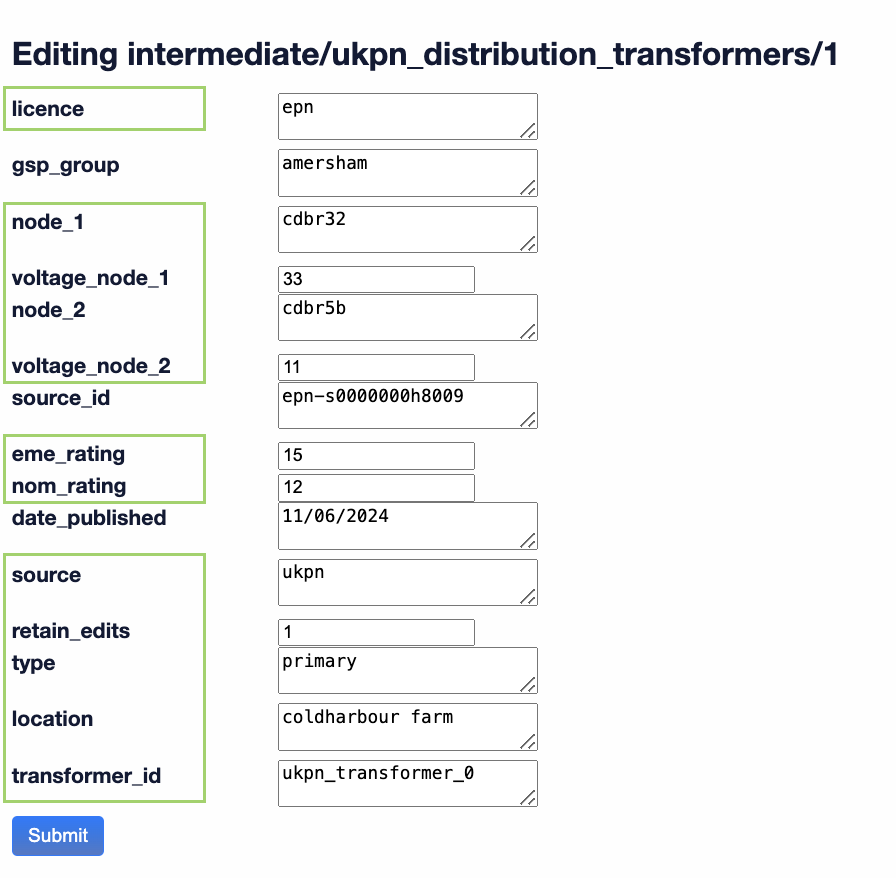

Adding a new transformer

  1. Create a new transformer entry in the intermediate transformer table
  2. Ensure that the fields in green are populated:
How to edit substation

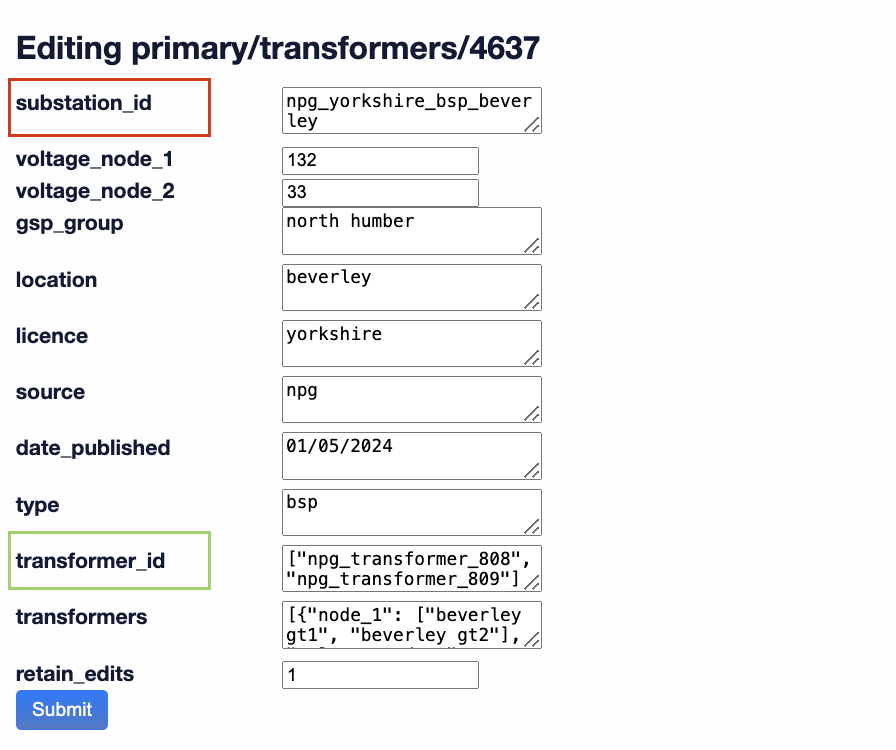

Modifying transformer assignments to a substation

In the primary transformer table, transformers are grouped by voltage and substation id.

How to edit substation

The modification of the primary transformer table should only be done as a last resort, if updating the intermediate transformer or substation table does not resolve the issue.

Transformer Flow

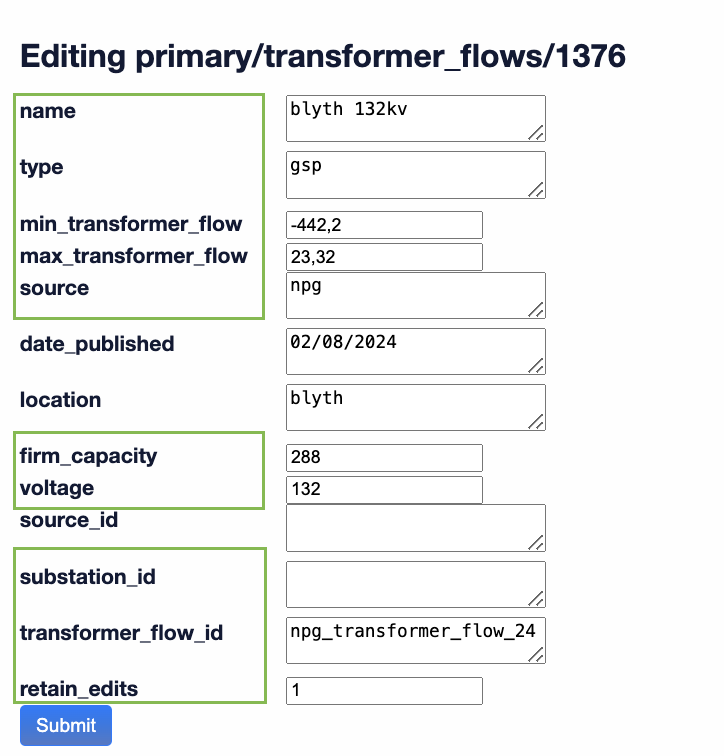

Adding a new transformer flow

  1. Create a new transformer flow entry in the primary transformer flow table
  2. Ensure that the fields in green are populated:
How to edit substation

Project

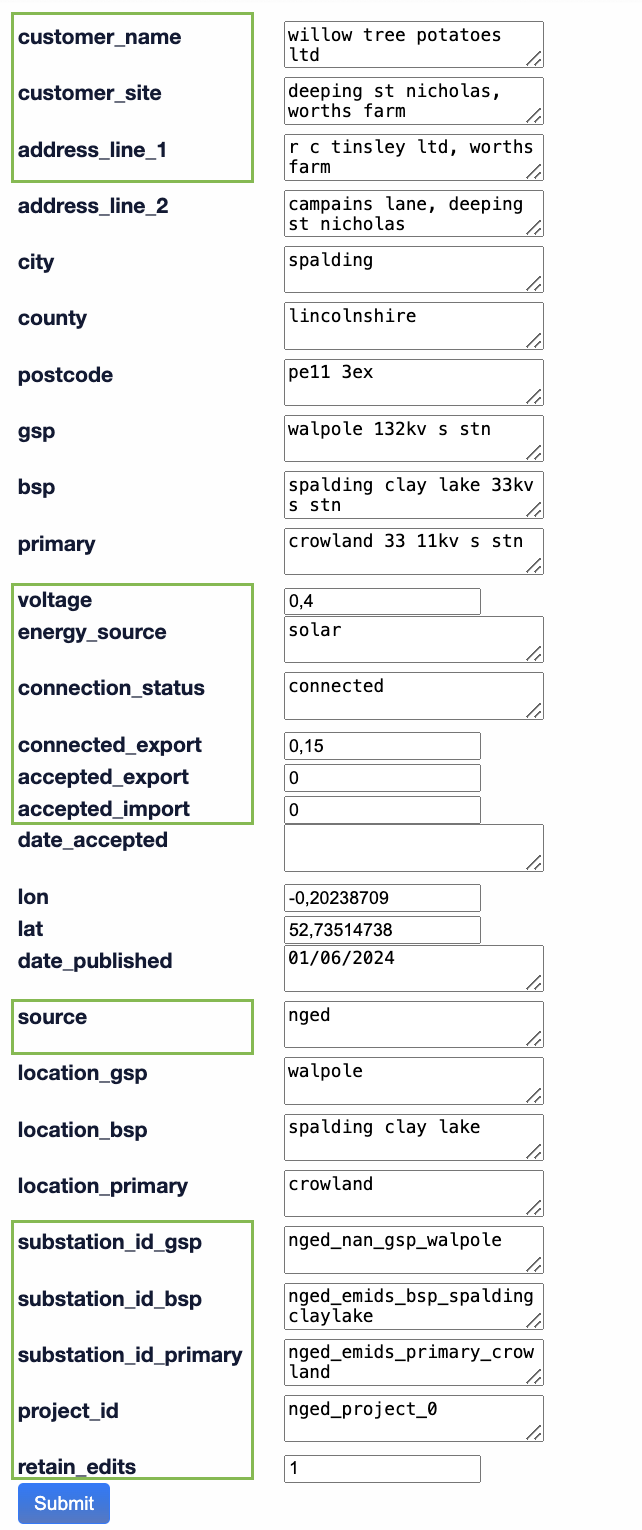

Adding a new ECR project:

  1. Create a new project entry in the primary ecr table
  2. Ensure that the fields in green are populated:
How to edit substation

Circuits

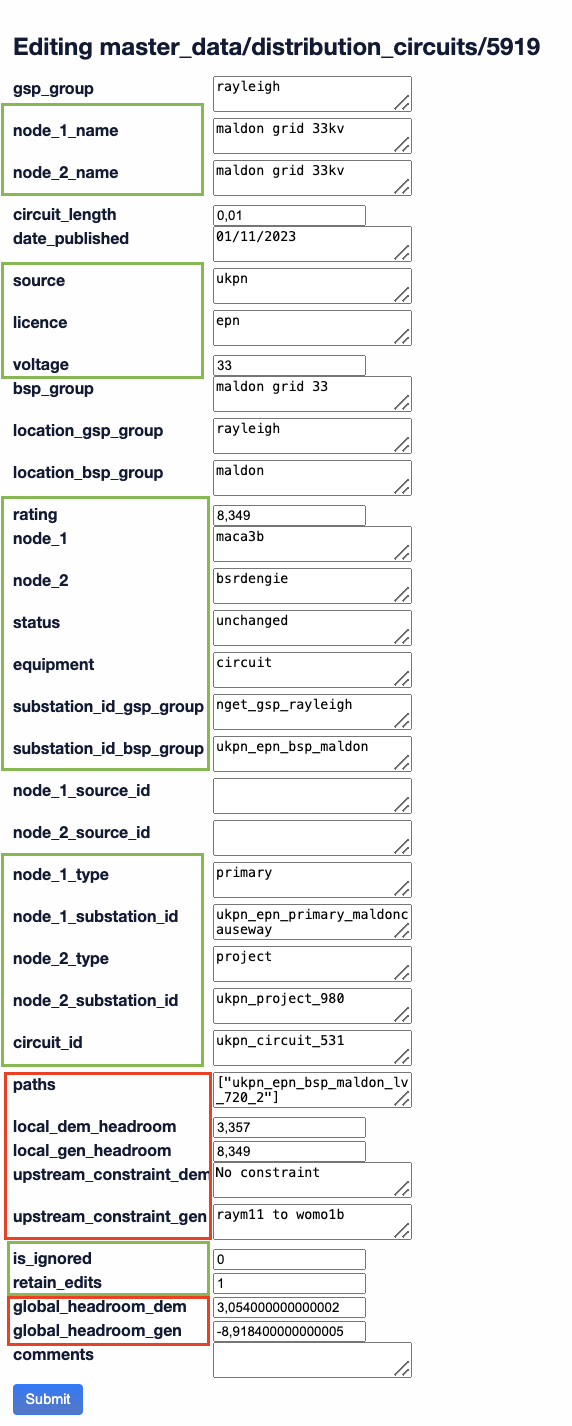

Adding a new circuit:

  1. Create a new entry in the master data circuits
  2. Ensure that the fields in green are populated:
How to edit substation

How are master_data_substation fields computed?

Substation_id

Object Object Fields Used
Substation Source Licence Type Location
Transformer Source Licence Type Location*
Transformer Flow Source Licence Type Location*
ECR Source Type Location*

*Fuzzy matched (a method for identifying strings that are similar but not identical, making it useful for matching data with typos, misspellings, or minor differences)

Min/Max Transformer Flow & Firm Capacity

Provider Substation Fields Used
NGED Substation_id
UKPN Substation_id
ENW Substation_id Transformer Voltage Node 1*
Other Provider Substation_id Transformer Voltage Node 2*
Provider TF Fields Used
All Substation_id Voltage*

*Tolerance of 2V is taken

Accepted Export/Import

Provider Substation Fields Used
All Substation_id Transformer Voltage Node 2*
Provider ECR Fields
All Substation_id_primary Substation_id_bsp Substation_id_gsp Voltage*

*Tolerance of 2V is taken

How are master_data_circuit fields computed?

Node 1 and Node 2 Type/Substation_id

There are two different methodologies for assigning substations to nodes:

  1. Methodology Based on Node Names:
  1. Methodology Based on Node IDs:

*Fuzzy matched (a method for identifying strings that are similar but not identical, making it useful for matching data with typos, misspellings, or minor differences)
